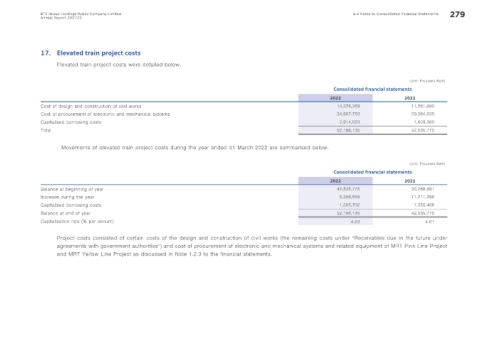

               17.  Elevated train project costs
                     Elevated train project costs were detailed below.


                                                                                                                                                (Unit: Thousand Baht)
                                                                                                                     Consolidated f nancial statements
                                                                                                                    2022                      2021
               Cost of design and construction of civil works                                                         14,376,359                11,561,880
               Cost of procurement of electronic and mechanical systems                                               34,907,753                29,364,535
               Capitalised borrowing costs                                                                             2,914,023                 1,609,360
               Total                                                                                                  52,198,135                42,535,775

                      Movements of elevated train project costs during the year ended 31 March 2022 are summarised below.


                                                                                                                                                (Unit: Thousand Baht)
                                                                                                                     Consolidated f nancial statements
                                                                                                                    2022                      2021
               Balance at beginning of year                                                                           42,535,775                30,268,891
               Increase during the year                                                                                8,356,658                11,211,398
               Capitalised borrowing costs                                                                             1,305,702                 1,055,486
               Balance at end of year                                                                                 52,198,135                42,535,775
               Capitalisation rate (% per annum)                                                                           4.53                      4.61


                     Project costs consisted of certain costs of the design and construction of civil works (the remaining costs under “Receivables due in the future under
                     agreements with government authorities”) and cost of procurement of electronic and mechanical systems and related equipment of MRT Pink Line Project
                     and MRT Yellow Line Project as discussed in Note 1.2.3 to the financial statements.
